The re-schedule analysis displays proposals suggesting that you re-schedule the manufacturing order either backwards or forwards.
Re-schedule backwards
If the quantity on hand is below the safety stock, the analysis proposes that you re-schedule the manufacturing order backwards. This means that the planned delivery date is changed to an earlier date.

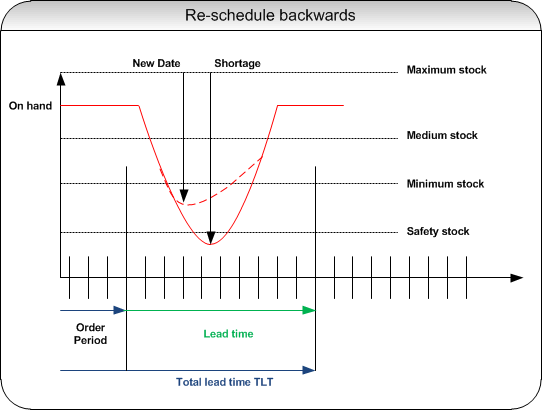

Flowchart

Re-schedule forwards
If there is a surplus the analysis proposes that you re-schedule the order forwards. This means that the manufacturing order is deleted.
Flowchart

- Select the Work with pull-planning menu item.
- You access Work with pull-planning, Order proposals. Select the analysis proposal that you want to work with and click Work w proposal.
- You access Work with analysis proposal. Complete the following field:
- Type of proposal
- Indicate the type of proposal to be maintained by ticking one of the following: Order proposal or Re-schedule proposal. For this task, tick Re-schedule proposal.
- You access Work with re-schedule analysis. (Tip: The Tp column displays a code indicating how the order should be re-scheduled. Permitted values: 1 (Backward) and 2 (Forward).) Select the item for which you want to view open orders and click Open orders.
- You access Work with re-schedule analysis, Open orders. Select the order you want to re-schedule and click Order maintenance.
- You access Manufacturing order maintenance, Header. You will have to manually change the date according to the action that was recommended by the system (forward or backward re-scheduling). Complete the following field:
- Planned compl. date
- Enter a date indicating the new completion date of the manufacturing order.
Click OK.
Click OK to update. Exit the routine.
Related topics
- About pull planning
- Create an analysis proposal for pull planning
- Update/re-create an analysis proposal for pull planning
- Set up shortage analysis values for pull planning
- Release manufacturing orders during pull planning
- Release purchase orders during pull planning
- Re-schedule purchase orders during pull planning
- Delete an analysis proposal for pull planning
